This is the ServiceNow version of the demo .For the JIRA version click here.
The demo code can be downloaded from our GitHub Repository
Purpose: To automate the delivery of most frequent JIRA project tasks, ServiceNow Change Requests. Automation loop: Closed-loop automation. No human interaction is required for normal operation, but if the workflow fails, it opens a follow up DBA Change Request to repair the issue with logs attached. Implementation: ServiceNow ITSM (Information Technology Service Management) Technology products: ServiceNow (Cloud) ServiceNow Certified Ansible ITSM Collection (running on s Cloud or On-prem VM) ó Assets (on-prem and Cloud-provisioned Oracle & SQL Server in need of provisioning and maintenance). Cost of product licenses: $0. ServiceNow operates as it is currently, no additional premium features enablement is necessary. The Ansible ITSM collection running from a LINUX automation control node is free. Ansible, a RedHat product, doesn’t charge for its simplest CLI core form – which is what is used in this POC, but charges for its Cloud Automation Platform – which is out the scope. Operational cost: The only expense is a LINUX automation control node running our custom workflows to handle all Oracle and SQL Server tickets and incidents. Alternatively, an on-premises LINUX server with 4CPUs and at least 64GB or RAM and 2TB storage will suffice. ServiceNow status progression: New, Assess, Authorize, Schedule, Implement, Review, Closed. The intent is to automate not just the DBA execution steps, but the entire ServiceNow Change Request and Incidents life cycle: from user opening a Change Request or probe detecting an operational SQL Server or Oracle failure all the way to resolving the incident and executing the requested change and to, finally, closing the CR or INC within SNOW, entirely unattended. JIRA task status progression: To Do, Pending Approval, In Progress, Done. The entire project life cycle executed automatically. Accessibility: The ServiceNow automation workspace is accessible in all browsers and most cell devices. The Change Requests may be opened, immediately auto executed and closed from a hand-held device:

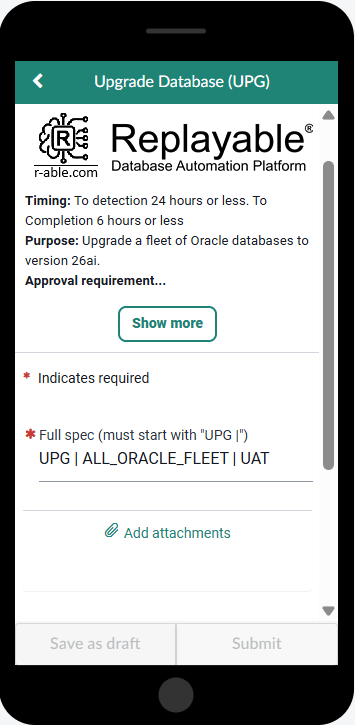

Pic 1. An example of Oracle upgrade intake form, as seen on an iPhone screen.
BENEFITS
1. Tool Consolidation
· Centralized Management: This solution provides a single interface to manage all ticketing, access, CMDB, approval, and automation workflows.
· Reduced Complexity: The current alternative relies on fragmented systems (e.g., access handled by one tool, approvals by another, and monitoring/automation via Oracle Enterprise Manager).
· Streamlined Operations: Consolidating these tools reduces system failure points, minimizes maintenance overhead, and eliminates communication gaps between disparate platforms.
2. License Cost Optimization
· Vendor Lock-In Relief: Fragmented ecosystems require separate licensing fees for each tool.
· Strategic Flexibility: Even with heavily discounted pricing, maintaining multiple tools locks the organization into specific vendors, making it difficult to pivot to better-suited products.
3. TCO Reduction
· Operational Savings: Software licensing typically represents only 20–30% of Total Cost of Ownership (TCO). The remaining 70–80% is driven by personnel-heavy maintenance, including patching, upgrades, bug fixes, data migrations, and ongoing support.
· Efficiency Gains: Transitioning to this automated platform can reduce overall TCO by 50–70% by eliminating repetitive manual labor.
· Process Optimization: Currently, employees must navigate lengthy Change Advisory Board (CAB), Jira, Agile, and Kanban approval cycles before executing scripts. Automating triaging, assignments, and tracking reclaims this lost time and effort.
4. Cloud Operational Cost Reduction
· Agentless Architecture: Traditional tools like Oracle Enterprise Manager (OEM) rely on heavy, platform-specific agents that constantly poll assets, generating expensive and unnecessary cloud traffic.
· Reduced Overhead: Ansible is agentless and operates on a push-only model. It connects on demand via standard protocols (SSH or WinRM), executes tasks, and immediately removes its footprint.
· Enhanced Security: Eliminating permanent local agents significantly reduces administrative overhead and minimizes the infrastructure's attack surface.
· Drift Prevention: This push-only architecture ensures configuration changes are only initiated by a centralized control node. This simplifies firewall configurations and prevents unauthorized local configuration drift.
5. Idempotency
· Predictable Execution: Ansible is idempotent by default. Running the same playbook multiple times on a target system will only execute changes if the current state deviates from the desired state.
· Risk Mitigation: In contrast, standard scripts execute blindly regardless of the system's current state, which introduces a high probability of operational failure.
6. Immutability
· Future-Proof Design: Conventional automation is rarely designed to support immutable infrastructure.
· Golden Image Deployment: While full immutability is a long-term goal, we can immediately leverage Ansible alongside Packer to bake packages, security updates, and application code directly into golden images. These can then be deployed as disposable, immutable instances, drastically reducing future code modification needs.
7. Scalability
· Eliminating Burnout: A conventional Database Administrator (DBA) handles an average of 20–30 tasks and incidents per week. If request volume spikes or priorities double, the workload quickly becomes unsustainable for a manual team, leading to burnout and turnover.
· Infinite Scaling: The automated solution scales up a thousand-fold instantly without requiring an upgrade to the control node. It can execute thousands of parallel tasks across thousands of databases simultaneously.
· Strategic Resource Shift: This automation elevates IT personnel from manual script runners to high-value infrastructure architects.
8. Speed
· Proven Performance: In a live test of a Database Change Request (DCR) project, the automated system successfully processed 1,000 migration Change Requests in 2 minutes and 52 seconds.
· Exponential Time Savings: For a team of five DBAs to complete the same workload manually, it would take an estimated month of continuous 24/7 operation, assuming zero interruptions from other incidents.
· Workflow Closed-Loop: Traditional open-loop workflows require manual intervention at every phase: request, route, approve, assign, execute, review, and close. Automation transitions this into a rapid, closed-loop process.
· Manual Delays: Under the current manual framework, the assessment, routing, approval, and implementation stages require days or even weeks to complete.
· Resource Constraints: Actual execution is frequently delayed by hours or days because administrators must prioritize critical production incidents, or may become unexpectedly unavailable. These resource dependencies create operational bottlenecks and force escalation managers to scramble for alternative coverage.
· End-to-End Resolution: Integrating ServiceNow ITSM automation eliminates these human bottlenecks. The entire change or incident lifecycle is automated end-to-end, executing tasks instantly once predefined criteria are met.

Pic 2. The Life Cycle of a Conventional ServiceNow Change Request

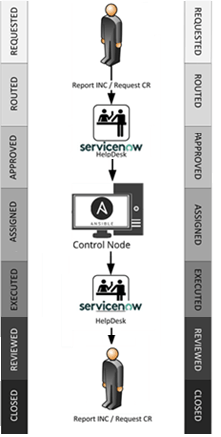

Pic 3. The Life Cycle of an Auutmated ServiceNow Change Request
9. Quality of Service
· The Cost of Downtime: For large enterprises, IT service delivery errors cost an average of $9,000 per minute. Major operational failures can be catastrophic; for example, the high-profile scheduling crisis at Southwest Airlines resulted in up to $825 million in total losses and a $140 million civil penalty.
· Reputational Impact: Beyond direct financial losses, system errors trigger stock price volatility and drive customer churn. Market research indicates that 85% of shoppers will abandon a retailer after a single poor delivery experience.
· Competitive Disadvantage: Manual processing introduces feature deployment delays, causing the organization to lag behind sufficiently automated competitors.
· The Baseline Error Rate: The average human input error rate sits at 4%, compounding with an additional 4% error rate during complex task execution (8% total). Common points of failure include executing scripts against the wrong database environment, entering incorrect credentials, or lacking the correct runtime components.
· The Log-Parsing Bottleneck: While Database Administrators (DBAs) attempt to check output logs for runtime errors (such as Oracle ORA- codes), manual verification is mathematically impossible when logs scale into gigabytes and staff must prioritize competing production incidents. This risk multiplies further during complex, inter-departmental operations due to communication gaps.
· Automated Precision: The proposed solution lowers the operational error rate to 0.01%. Remaining anomalies are restricted to input parameters (e.g., a user inputting an incorrect date or schema name) rather than automation execution failures.
· Closed-Loop Quality Control: The system executes workflows precisely, uniformly, and on schedule according to vendor best practices. It scans thousands of execution logs in parallel and in real time. If an anomaly is detected, it automatically generates a ticket, attaches the relevant error log fragment, and alerts the DBA for targeted intervention.
10. Security
· Current Vulnerabilities: Our existing manual framework requires a DBA password for script execution. Storing plaintext credentials on a server hard drive—even temporarily—violates basic database security compliance. Unencrypted network communications pose a similar risk.
· Industry-Standard Encryption: Ansible Vault leverages AES-256 symmetric encryption to secure sensitive files, certificates, API keys, and individual runtime variables.
· Zero-Trust Credential Handling: By shifting to automated password handling, sensitive parameters are hidden from the local server and the transit network.
· Encrypted Secrets Management: Entire connection strings—including usernames, passwords, runtime variables, and cloud endpoints—are fully encrypted in the vault. The automation engine can safely ingest these payloads to execute tasks without exposing raw credentials to human operators or log outputs.

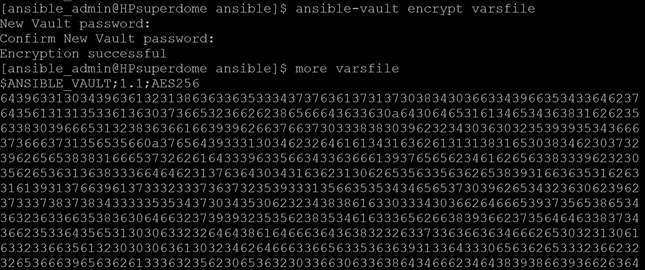

Pic 4. A variables and passwords file encrypted by Ansible vault
11. Accountability
· Managing Cloud Complexity: In traditional on-premises environments, manual errors were isolated. In multi-cloud ecosystems, the rapid pace of change across diverse vendor platforms makes relying on human memory an operational risk.
· Single Source of Truth: Automation centralizes governance by consolidating infrastructure code into a single repository (e.g., GitHub or GitLab), securing secrets within an encrypted vault, and logging execution trails directly inside the ticketing system (e.g., Jira or ServiceNow).
· Vendor-Agnostic Governance: Because the framework is vendor- and technology-agnostic, it establishes a transparent audit trail. Every deployment clearly documents what action was taken, where it occurred, when it executed, and why it was triggered, ensuring total accountability and predictable results.
12. Ownership
· Eliminating Institutional Knowledge Silos: Traditional, open-loop automation scripts typically exist as siloed knowledge held by individual authors. When a team member leaves the organization, that operational knowledge departs with them.
· Reducing Onboarding Overhead: Inheriting legacy shell or CLI scripts forces replacement DBAs to spend significant time decrypting custom code, which frequently leads to rewriting tools from scratch. This creates a repetitive, costly cycle of throwaway engineering.
· Institutional Asset Retention: Closed-loop automation transforms individual knowledge into corporate assets via version-controlled configuration files. All operational logic is permanently stored, versioned, and tagged within a central repository.
· Modular Continuity: Because the infrastructure definition is modular and declarative, incoming engineers can safely run, maintain, and scale the workflows without navigating undocumented, bespoke scripting logic.
Database Hyper-Automation Platform: The Use
To simplify, there is a custom workspace within a ServiceNow instance. It is a collection of custom ServiceNow forms connected to prepared Change Request templates for most requested work. The user accesses the main site via his/hers ServiceNow URL, finds the Database Automation Platform by either searching the ServiceNow filter, or by accessing it from a previously saved Favorites link:
Pic 5. Access to the main automation Workspace
The main menu contains nine Change Request intake forms, one for each of the most frequently requested Change Requests and Tasks, as evidenced from the past 2 months’ use.
Change Database Password (CDP)
Create Application User (CAU)
Database/Schema Refresh (REF)
Drop/Decommission Database (DDP)
Fix Performance (PRF)
Migration/Data Change Request (DCR)
Patch Database (PAT)
Provision Database (PDB)
Upgrade Database (UPG)

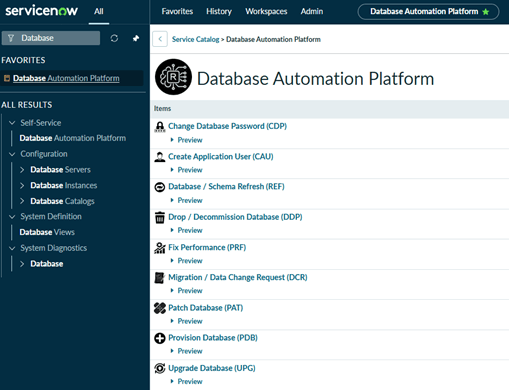

Pic 6. The 9 Change Request intake forms accessible from the main Workspace
The purpose of the CR intake forms is twofold - to make sure that the user supplies the required automation runtime parameters, and to make sure that only the absolute minimum of information is requested from the user, with all additional data prefilled by the CR template.
Let’s pick one of the nine database CR intake forms, “Migration / Data Change Request”. Here is the intake form that opens from the main Workspace link.
The user enters the three required parameters: Target Environment: DEV Short title for the Change Request: Main site migration script run Uploads the script or multiple scripts to be run against the database by clicking on the Click to add an attachment link (expenses.sql)
Some Change Request intake forms require database instance or user metadata to be executed. This happens every 60 seconds without any human input. The automation control node simply queries the database when the CR must be open. Rest assured, the metadata is the single source of truth (derived directly from the asset) and it is no more than 60 seconds old.

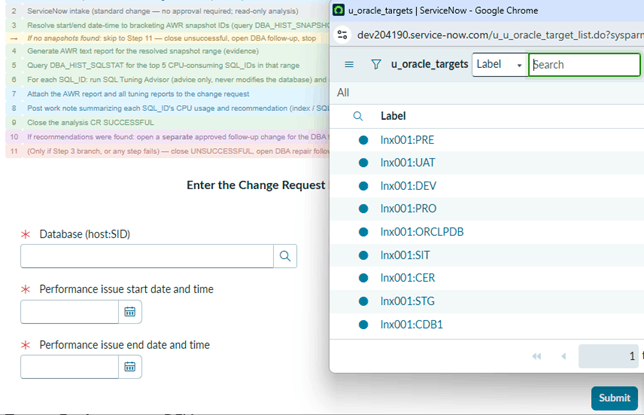

Here is a view of a performance resolution Change Request, which pulls the database instances list on opening. The PRE database on that list was created exactly two minutes ago!
Pic 8. Real-time parameters (a list of current databases)
Next, the user clicks on the Submit button. The form is feeding the parameters into a ServiceNow Change Request template created for this type of change only.
The next screen opens the actual Change Request with all the data already inside.

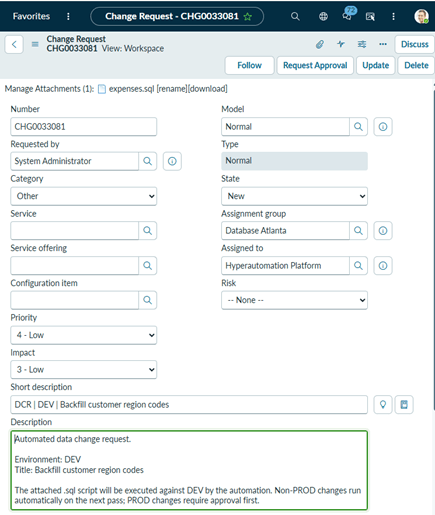

Pic 9. An automated Change request opened by initial intake form from the Database Automated Platform
Depending on the type of Change Request, it may not require approval or require several of those (management and/or full CAB approvals). After filling out the intake form, the user then clicks on Request Approval. The Change Request is sent to the approvers queue and will remain there until approved. If it requires CAB approval it will meet the same fate. For the most destructive or irreversible Change Requests all CAB members’ approval is necessary before execution commences.

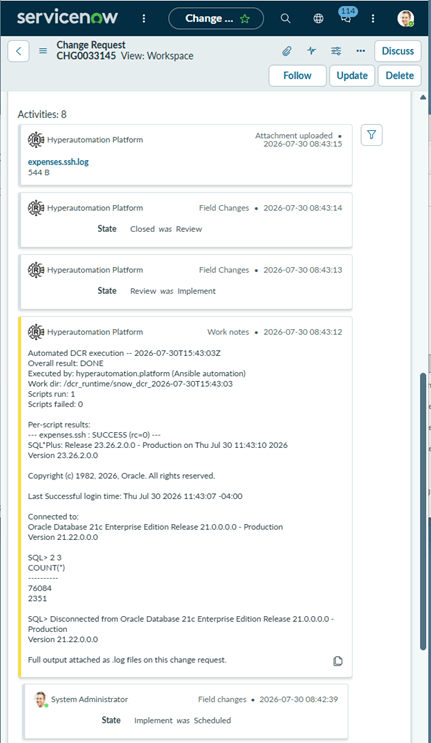

Pic 10. The view of the notes the automation posted. The CR was opened at 08:42, executed and closed at 8:43, one minute later
Here is what happens behind the scenes. The LINUX Ansible automation control node polls the ServiceNow API every 60 seconds to detect new Change Requests. If a CR is opened and approved, the control node executes it immediately. It pulls the relevant Ansible automation YML playbook.

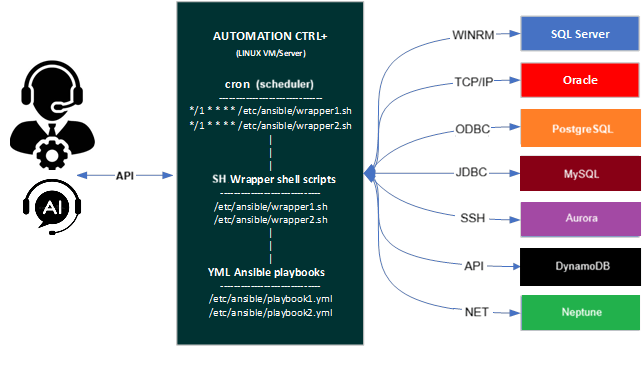

Pic 11. Product Architecture.
If the Change Request has a scheduled implementation day and time (and, again, the necessary approvals) it will wait till the indicated time. Some long-term Change Requests are instructed to only be executed off business hours or during weekends, such as Oracle patching or upgrades to 26ai.
If the automation control inventory specifies a thousand database servers as targets, as in the case of such bulk CR executions as fleet upgrades (for example, the Ansible inventory shows “NA_FLEET” with a thousand unique AWS RDS instance names), it executes the task on all of them at the same time. For the Change Requests executed successfully, the control node enters a success message to the Change Request. For the failed hosts the control node opens a follow-up Change Request for the human DBA team (at that should be the only extent of their involvement in all 9 types of activities on the main Workspace page).
Here is a normal Change Request queue for the automated ServiceNow Workspace Database Automation Platform. All these requests were handled by automation, from detecting their existence and the state of approvals, all the way to execution, verification and user notification upon a closure.
Pic 12. A standard view of an automated Change Request queue
All of them were opened by actual users, but executed by automation, except for CHG0033073 and CHG0080. Those two were open by the automation control node as follow-up Change Requests for the DBA team to investigate own automation failure.

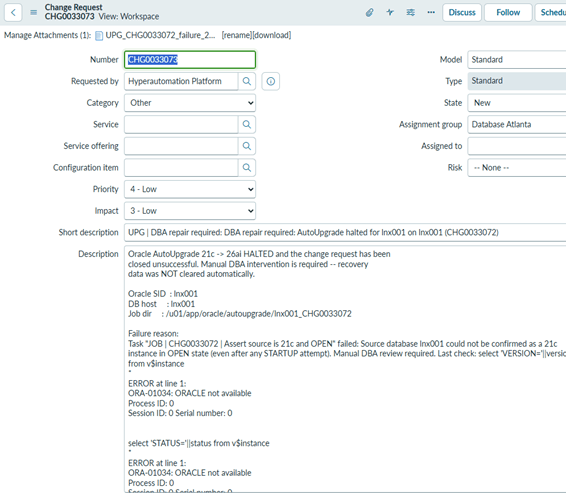

Pic 13. An example of a DBA follow up Change Request the automation opens if it fails a database upgrade
Here is a view of the Notes section of a closed and successfully executed Change Request:
Pic 14. A view of the Notes section of a closed Oracle database upgrade Change Request
The intent is for all, or at least most routine work, to be executed by automation, with only the failures to be repaired by humans; and the fixes factored into the automation logic later, so the failures do not re-occur. The DBAs should handle no more than 5% of their normal load during the first 4-6 months, when automation bugs are common, but the number decreases to 0.5% or lower afterwards.
Although the number of the automated Change Requests may increase over time and expand to other areas, tasks or products (Exadata, GoldenGate, etc.), not everything may or should be automated. For example, all activities involving exploratory intervention (those requiring intuition, rather than a predefined sequence of known tasks with already tested set of outcomes and possible error resolutions) are poor ITSM automation candidates. Those require too much automation coding for very little to show for it long-term.
Change Requests Automation Workflows
Each Change Request intake form has a simplified version of the relevant workflow. Here is an example:

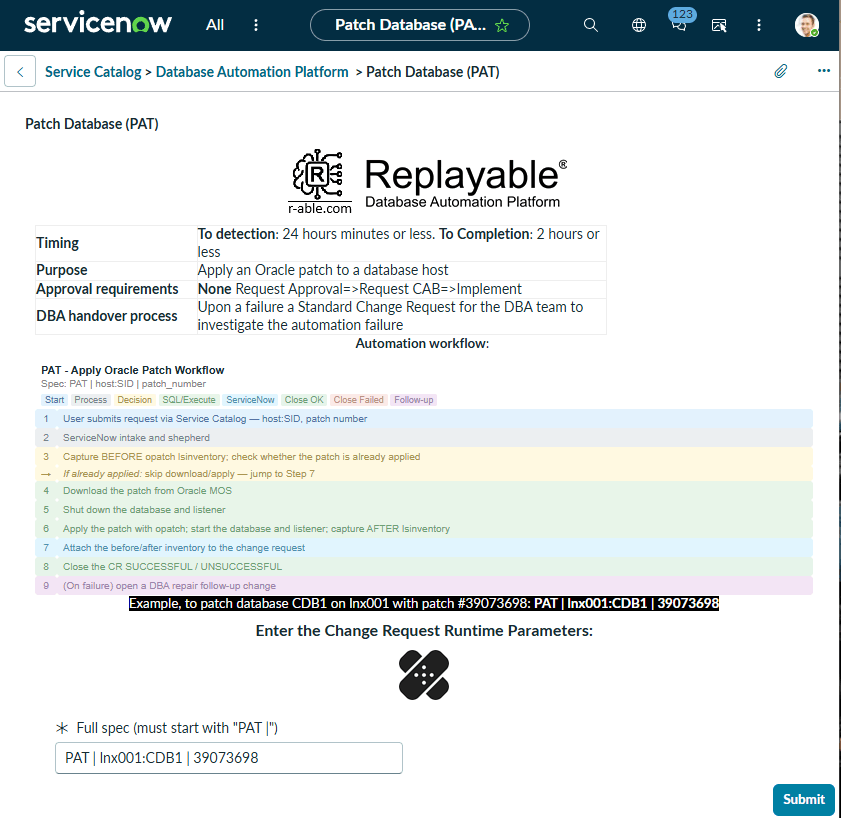

Pic 15. A view of a Change Request intake form for patching a database with Oracle patch with the simplified automation workflow shown in color
The following are detailed automated workflows coded in Ansible YML.
The following are simplified automation workflows coded in Ansible YML. ServiceNow implementation.
REF - Environment Refresh Workflow (SIMPLIFIED, ITIL-ALIGNED) Spec: REF | SOURCE:TARGET (legacy: SRC_SVC:SRC_SCHEMA=>TGT_SVC:TGT_SCHEMA) 3-play structure: PLAY1/PLAY3 run on the controller, PLAY2 runs directly on the Oracle host. Includes ITIL change classification and documented risk-mitigation controls
PRE-FLIGHT: remove stale outcomes file from any aborted previous run
3
0-1: ServiceNow intake and shepherd for REF (standard, NO APPROVAL)
4
1: show 'No Tasks Found' and exit cleanly when queue is empty
→
WARN: missing or invalid refresh spec — skipped
5
2: parse refresh spec (legacy vs new format, service aliases)
6
2: show parsed refresh jobs
7
2: write refresh job list to temp file for PLAY 2
8
PLAY2-INIT: read + decode refresh job list
8b
ITIL alignment: classify this refresh — link the CMDB Configuration Item to the target service, set risk=Low/impact=Low, and record a planned 4-hour change window
9
PRE-FLIGHT: confirm expdp binary exists — fail if not
10
PRE-FLIGHT: confirm impdp binary exists — fail if not
11
PRE-FLIGHT: confirm DATA_PUMP_DIR exists and is writable
→
Risk mitigation: confirming the tools and destination directory exist before touching any schema avoids a half-completed export with nowhere to land
12
JOB: set per-job file names + full paths
13
JOB: confirm source schema exists — fail if not
14
JOB: export source schema — fail if export failed
15
JOB: drop target schema (idempotent)
→
Best practice: the drop is written to be idempotent, skipping cleanly if the target schema doesn't already exist, rather than erroring on a fresh target
16
JOB: import target schema
17
JOB: count objects in target schema
→
Risk mitigation: counting imported objects verifies the refresh actually landed data, rather than trusting a clean import exit code alone
18
JOB: post export/import results as work note
19
JOB: remove dump + log files (success only)
→
Cost containment: removing the export dump file after a successful refresh avoids accumulating storage from repeated refresh cycles
20
JOB: preserve export/import output on controller (failed only)
ITIL alignment: classify each job — link the CMDB Configuration Item to the target CDB, set risk=Medium/impact=Low, and record a planned 1-hour change window
9
2: new change: request approval (state=assess)
10
2: work note: awaiting approval
11
2: advance: Assess → Authorize
12
2: advance: Authorize → Scheduled
13
2: advance: Scheduled → Implement
→
WARN: if a change could not be advanced
14
2: re-query for CRs genuinely at Implement now
15
2: filter pdb_jobs to only genuinely-implemented ones
→
Risk mitigation: re-querying live state rather than trusting a cached approval status prevents creating a PDB against a request that isn't genuinely approved yet
4: create datafile directory when OMF is not in use
22
4: create, open and save the state of the PDB
23
4: show the creation outcome (no credentials)
→
Best practice: the admin password never appears in this outcome log — it's disclosed exactly once, in a dedicated work note, never written to disk logs
24
5: capture v$pdbs after the operation
25
5: determine the outcome for each change
26
5: per-change outcome
27
6: ensure the log directory exists
28
6: set the run timestamp
29
6: write the evidence log for each change
30
6: attach the evidence log to the change request
→
WARN: if evidence log could not be attached
31
7: post the result work note
→
Confirm the work notes were posted
32
8: move changes to review
33
8: close SUCCESSFUL changes (close_code successful)
Drop Pluggable Database (DDP) — ServiceNow-driven decommission
2
Parse DDP spec: 'DDP | host | CDB | PDB'
3
Extract spec fields
→
Malformed spec — skip this CR
→
Unknown host — skip this CR
4
Resolve oracle_home/SID/user from oracle_instance_map
4b
ITIL alignment: classify this drop — link the CMDB Configuration Item to host:CDB:PDB, set risk=High/impact=Medium, and record a planned 1-hour change window
5
Set ready-to-execute flag default
6
New change: promote to Assess, hold for approval
7
Pending approval or mid-walk: advance if approved
8
Already at Implement — ready to execute
→
Not ready this pass — stop here
9
Check for required confirmation line
10
Escalate block reason if target is protected
→
Risk mitigation: a literal 'CONFIRM DROP <PDB>' phrase requirement plus a protected-name blocklist together prevent an accidental or automated drop of the wrong or a protected database
→
Handle blocked drop — close unsuccessful with follow-up
11
Ensure base working directory exists, world-traversable
12
Ensure remote working directory exists
13
Write pre-drop snapshot SQL
→
Best practice: capturing a full pre-drop snapshot (DBA_PDBS, tablespaces, datafiles) before an irreversible operation preserves evidence of exactly what existed beforehand
14
Write drop SQL — close then drop including datafiles
Refine outcome by scanning log lines for ORA- errors
21
Downgrade to failure if any ORA- error line is present
→
Risk mitigation: scanning the actual log content for error patterns, not just the shell exit code, catches a drop that partially failed but still returned success
22
Attach snapshot + drop logs to the change request
→
WARN: if any log failed to attach
23
Post work note — outcome summary
24
Walk Implement → Review
25
Walk Review → Closed successful
26
Walk Review → Closed unsuccessful
→
WARN: if this CR could not be closed
27
Open DBA follow-up on failed drop
DCR - Run Data Change Script Workflow (SIMPLIFIED, ITIL-ALIGNED) Spec: DCR | ENVIRONMENT | title (+ .sql attachment) MANAGEMENT approval for PROD only. Includes ITIL change classification and documented risk-mitigation controls. Own custom intake (not COMMON_snow_intake.yml)
0: abort with clear message if instance unreachable (HIBERNATING PDI / 401 check)
4
0: query DCR-tagged CRs in new/assess/authorize/scheduled/implement
5
0: collect tagged CRs, parse target environment
6
0: annotate each change: env + is_prod flag from short_description
7
0: intake summary
7b
ITIL alignment: classify each change — link the CMDB Configuration Item by environment, set risk=Medium/impact=Medium, and record a planned 1-hour change window
WARN: NON-PROD change could not advance to implement
10
0: PROD: request approval (state=assess, no CAB)
→
Risk mitigation: PROD-only approval gating reserves the highest-consequence environment for human review while non-PROD stays fast-moving and low-friction
Best practice: scanning execution logs for error patterns (ORA-/SP2-/ERROR/WARN) rather than trusting exit codes alone catches partial or silent failures
30
6d: show detailed error report for failed scripts
31
7: mark issue FAILED if any script rc≠0, else DONE
32
7: show final per-issue outcomes
33
7b: post work-note summary per change
34
8: move SUCCESSFUL to Review + Close SUCCESSFUL
35
9: move FAILED to Review (required before closing) + Close FAILED
→
WARN: if FAILED change could not be closed
36
10: upload execution logs as ServiceNow attachments
1: show 'No Tasks Found', end play when queue empty
→
WARN: missing user name or databases — skipped
3
2: build change → user + target databases mapping
4
2: show user → Oracle username → databases mapping
4b
ITIL alignment: classify each job — link the CMDB Configuration Item to the primary target database, set risk=Low/impact=Low, and record a planned 1-hour change window
5
3: generate random password for each issue
→
Best practice: a single generated 16-character password (upper/lower/digit/special) replaces any hand-typed or reused credential, and never touches Ansible logs (no_log)
6
3: attach generated password to each issue entry
7
4: create Oracle user + grant privileges in each target database
8
4b: show create-user outcome per issue per database
9
4c: set log run timestamp
10
4c: ensure the CAU log directory exists
11
4c: write the execution log for each change
12
4c: upload the execution log to the change request
→
WARN: if execution log could not be attached
13
5: write worklog payload JSON to a temp file
14
5a: write worklog-posting Python script to temp file
15
5b: execute the work-note-posting script against payload
16
5c: show work-note posting outcome (no credentials)
→
WARN: if the work-note script failed
17
5d: clean up temp payload and script files
18
6: mark issues DONE (all databases succeeded)
19
6: mark issues FAILED (any database failed)
20
6: move SUCCESSFUL to review, Close SUCCESSFUL
21
6: work-note FAILED changes with failure summary
22
6: close FAILED changes (close_code unsuccessful)
23
6c: write failure report per FAILED issue
24
6c: create DBA follow-up task for FAILED issues
25
7: build + print final summary
PAT - Apply Oracle Patch Workflow (SIMPLIFIED, ITIL-ALIGNED) Spec: PAT | host:SID | patch_number MANAGEMENT+CAB approval required. Includes orchestration dependency gating, ITIL change classification, and documented risk-mitigation controls
PLAY1: fetch ServiceNow PAT changes and build patch job list
2
0: remove stale per-issue and combined outcome files from any prior run
3
0-1: ServiceNow intake and shepherd for PAT (MANAGEMENT+CAB)
4
1: show 'No Tasks Found' and exit cleanly when queue is empty
5
2: WARN and skip changes with a missing or unknown patch target
6
2: build patch job list from change requests
7
3: write patch job list to temp file for PLAY 2 + ServiceNow credential sidecar
8
ORCHESTRATION GATE CHECK per job: any unsatisfied 'pre' dependency registered? (e.g. app server not yet stopped)
→
First encounter: spawn dependent CR (e.g. APPSTOP), insert orchestration_run + step — gate NOT clear this pass
→
Nothing left this pass: end play, retry next cron cycle
8b
ITIL alignment: classify each remaining job — link the CMDB Configuration Item, set risk=Medium/impact=Medium, and record a planned 2-hour change window
9
PLAY2-INIT: read + decode patch job list
10
JOB: set Oracle environment for target host
11
JOB: work note: patching started
12
JOB: run opatch lsinventory (BEFORE patching, full output)
13
JOB: flag whether the patch is already applied
→
Best practice: checking whether the patch is already applied avoids a redundant, risk-bearing re-application against a system already in the target state
14
JOB: write + upload BEFORE inventory to the change request
15
JOB: create patch staging directory on target host
16
JOB: download patch from Oracle MOS (on controller) — fail if download failed
17
JOB: copy zip to target host, unzip — fail if unzip failed
18
JOB: check current vs. required OPatch version (from patch README)
19
JOB: download + install new OPatch (6880880) if upgrade needed
20
JOB: stop listener (if running)
21
JOB: shut down Oracle database — fail if not clean
→
Risk mitigation: refusing to proceed on an unclean shutdown prevents applying a binary patch underneath a database that hasn't fully released its files
22
JOB: kill remaining oracle processes using ORACLE_HOME (CheckActiveFilesAndExecutables)
23
JOB: ensure + verify patch directory readable by oracle
24
JOB: apply patch with opatch
25
JOB: start Oracle database, start listener
26
JOB: opatch lsinventory AFTER (confirm patch listed)
→
Risk mitigation: confirming the patch actually appears in the inventory after applying it, rather than trusting a clean exit code alone
27
JOB: write + upload AFTER inventory to the change request
28
JOB: determine overall job outcome
29
JOB: remove patch zip + extracted directory
→
Cost containment: removing the downloaded patch archive and staging files immediately after use avoids accumulating unnecessary disk consumption across repeated patch cycles
30
JOB: write per-issue outcome JSON, merge into combined outcomes file on controller
31
ORCHESTRATION FIRE POST for successful issues: check dependency_registry, open dependent CR (e.g. APPSTART) automatically
32
PLAY3-INIT: read + decode patch outcomes
33
10: post worklog entry per issue
34
11: move SUCCESSFUL to review, Close SUCCESSFUL
35
11: work-note FAILED changes with failure summary
36
11: close FAILED changes (close_code unsuccessful)
37
11b: write failure report per FAILED issue
38
11b: create DBA repair follow-up change
39
12: print final summary + clean up temp files
CDP - Change Database Password Workflow (SIMPLIFIED, ITIL-ALIGNED) Spec: CDP | Full Name NO APPROVAL. Includes ITIL change classification and documented best-practice controls
ITIL alignment: classify each reset — link the CMDB Configuration Item to the Oracle user account, set risk=Low/impact=Low, and record a planned 1-hour change window
5
3: generate random password for each Oracle user
6
3: attach generated password to each issue entry
7
4: reset Oracle password for each user in each database
8
4b: show password-reset outcome per issue per database
9
5: post new temporary password as work note (all databases succeeded)
→
Best practice: the new password is disclosed only once all environments confirm success — a partial failure never leaves the requester with a password that only works in some databases
→
WARN: if the password work note could not be posted
10
6: mark issues DONE (all databases succeeded)
11
6: mark issues FAILED (any database failed)
12
6: move SUCCESSFUL to review, Close SUCCESSFUL
13
6: post failure work note and close FAILED changes
14
6c: set follow-up run timestamp
15
6c: ensure follow-up log dir exists
16
6c: write failure report (no stdout — may contain credentials)
→
Risk mitigation: the failure report deliberately omits raw stdout, which could contain a partially-applied password, keeping credentials out of any log a wider audience might read
Risk mitigation: validating the target software exists before any change work begins prevents a doomed run from ever reaching production data
4
PRE: ServiceNow intake and shepherd for UPG (MANAGEMENT+CAB)
5
PRE: nothing to do? end play when queue is empty
6
PRE: build upgrade job list from change requests
7
JOB: dispatch upgrade job per issue
8
JOB: set per-job facts
9
JOB: work note: upgrade started
10
JOB: write source DB check script
11
JOB: check source DB version and state
12
JOB: detect whether the database is already upgraded
→
If already upgraded: work note + close successful when already upgraded — done, no further action
→
Best practice: idempotency check prevents a duplicate upgrade attempt against an already-upgraded database
13
JOB: determine whether a STARTUP is needed
14
JOB: bring the database to OPEN when it is not
15
JOB: assert source is 21c and OPEN
15b
ITIL alignment: classify this change — link the CMDB Configuration Item, set risk=High/impact=High, and record a planned change window (Forward Schedule of Change)
Cost containment gate: check/request cost approval (COMMON_snow_cost_check.yml) — creates a u_cost_approval record on first encounter
→
If budget not yet approved: stop here for this issue, retry next pass (meta: end_host) — no clone or disk work begins until a budget owner approves
→
Cost containment: gating the storage-heavy clone behind explicit budget approval prevents surprise infrastructure charges before they're incurred, not after
18
JOB: create job directories
19
JOB: write autoupgrade.cfg
20
JOB: write AutoUpgrade analyze script
21
JOB: run AutoUpgrade ANALYZE phase (pre-upgrade check)
22
JOB: parse analyze summary
23
JOB: assert analyze passed
→
Risk mitigation: the ANALYZE phase surfaces upgrade-blocking issues before any irreversible change is attempted
24
JOB: read analyze status.log
25
JOB: work note: analyze complete
26
JOB: write AutoUpgrade deploy script
27
JOB: launch AutoUpgrade DEPLOY (async)
28
JOB: wait for deploy to finish (can take hours)
29
JOB: parse deploy summary
30
JOB: assert deploy succeeded
31
JOB: write post-upgrade bounce/verify script
32
JOB: restart database under 26ai home and verify
33
JOB: assert database is on 26ai and OPEN
34
JOB: ensure /etc/oratab points at 26ai home
35
JOB: work note: upgrade complete (Guaranteed Restore Point retained deliberately)
→
Best practice: the Guaranteed Restore Point is deliberately kept after success, not dropped immediately — a real rollback path stays available through the post-upgrade observation window
36
JOB: move change to review
37
JOB: close change (close_code successful)
38
JOB: WARN if the change could not be closed
→
Any of the assertions above failing: JOB: classify failure (special-cases stale recovery data, with resume/clear guidance)
→
Best practice: failure classification distinguishes a genuinely new failure from stale recovery data left behind by an earlier interrupted run, avoiding a misleading diagnosis
39
JOB: work note: upgrade failed, DBA review required
40
JOB: close change (close_code unsuccessful)
41
JOB: write failure report for follow-up
42
JOB: fetch AutoUpgrade status.log from host
43
JOB: create DBA repair follow-up task
44
JOB: clean up temp scripts
PRF - AWR Performance Analysis Workflow (SIMPLIFIED, ITIL-ALIGNED) Spec: PRF | host | ORACLE_SID | START_DATETIME | END_DATETIME NO APPROVAL — read-only analysis. Includes ITIL change classification and documented risk-mitigation controls
PRE: build job list (split short_description: host/SID/start_dt/end_dt)
→
WARN: unusable spec — expects date-times like '2026-02-21 21:02:00'
→
Unknown host — skip this CR
4
JOB: resolve oracle_home/user from oracle_instance_map
5
JOB: set per-job facts
5b
ITIL alignment: classify this analysis — link the CMDB Configuration Item to host:SID, set risk=Low/impact=Low, and record a planned 1-hour change window
JOB: execute tuning advisor per SQL_ID (ALTER SESSION SET CONTAINER first)
→
Risk mitigation: the SQL Tuning Advisor only ever produces advice — execute_tuning_task never modifies the database, so this entire analysis carries zero write risk to production data
22
JOB: read each tuning advisor report
23
JOB: build one-line recommendation summary per SQL_ID
24
JOB: attach AWR report to the change request
25
JOB: attach each tuning report to the change request
26
JOB: post analysis summary work note
27
JOB: walk Implement → Review
28
JOB: close successful
29
JOB: close unsuccessful
30
JOB: open follow-up for DBA team to implement fixes
→
Best practice: any recommended fix (new index, SQL Profile) is routed through a separate, approval-gated follow-up change rather than applied automatically — analysis and implementation stay cleanly separated
This same governance extends to the migration itself — assessing risk, tracking conversion, and managing cutover for teams moving off Oracle onto AWS. See our approach to Oracle-to-AWS migration →
